  #10221
Old Posted Apr 18, 2019, 12:35 PM
Truenorth00 Truenorth00 is offline
Registered User

Join Date: May 2017
Posts: 28,904
Anyone know when STO plans to transition to the LRT integrated bus routes? Have they announced a timeline? It's it right away? Weeks or months later?


  #10222
Old Posted Apr 18, 2019, 12:58 PM
J.OT13's Avatar
J.OT13 J.OT13 is offline
Moderator

Join Date: Mar 2012
Location: Ottawa
Posts: 28,773
Quote:
Originally Posted by Truenorth00 View Post
Anyone know when STO plans to transition to the LRT integrated bus routes? Have they announced a timeline? It's it right away? Weeks or months later?
No timeline. I assume it will be during the general schedule update after the line opens. So if the line opens this summer, the STO will likely implement the new routes for September 1.


  #10223
Old Posted Apr 18, 2019, 1:52 PM
cprail's Avatar
cprail cprail is offline
karatéka

Join Date: Dec 2004
Location: Montréal, Québec
Posts: 238
Quote:
Originally Posted by bradnixon View Post
Does that mean you can walk straight up the stairs from the O-Train platform to the westbound bus stop?
Yup! I took a few pictures this morning: https://mtlurb.com/topic/16449-ottawa-o-train-lrt/?do=findComment&comment=362857


  #10224
Old Posted Apr 18, 2019, 2:00 PM
J.OT13's Avatar
J.OT13 J.OT13 is offline
Moderator

Join Date: Mar 2012
Location: Ottawa
Posts: 28,773
Quote:
Originally Posted by cprail View Post
Thanks for the pics!

Took a quick walk on Queen yesterday. "O" decals have been installed at Lyon lanterns and the SunLife entrance of Parliament. The name of the stations have not been added. I wonder if the opted not to have the names on the lanterns with the "O". Other than Lees, where it was later removed, I've only seen a picture of the name on the ticket vending machine lantern at Blair, but with no "O".


  #10225
Old Posted Apr 18, 2019, 2:15 PM
corynv corynv is offline
Registered User

Join Date: Jun 2018
Posts: 171
Quote:
Originally Posted by Truenorth00 View Post
Anyone know when STO plans to transition to the LRT integrated bus routes? Have they announced a timeline? It's it right away? Weeks or months later?
No exact timeline, but they said they wouldn't transition immediately (need to wait for OC Transpo's transition to finish before they can really ramp up on their new routing). Though they have said route 20 will change immediately, just so they can test the route, and depending on how that goes they'll transition routes. But no timeline besides that.


  #10226
Old Posted Apr 18, 2019, 2:18 PM
Acajack's Avatar
Acajack Acajack is offline
Gros Méchant Loup

Join Date: Aug 2006
Location: Province 2, Canadian Empire
Posts: 72,949
Quote:
Originally Posted by corynv View Post
No exact timeline, but they said they wouldn't transition immediately (need to wait for OC Transpo's transition to finish before they can really ramp up on their new routing). Though they have said route 20 will change immediately, just so they can test the route, and depending on how that goes they'll transition routes. But no timeline besides that.
I receive the STO's newsletters and alerts, and so far have not heard anything more than that.
__________________
Loin des yeux, loin du coeur.


  #10227
Old Posted Apr 18, 2019, 2:19 PM
Acajack's Avatar
Acajack Acajack is offline
Gros Méchant Loup

Join Date: Aug 2006
Location: Province 2, Canadian Empire
Posts: 72,949
Quote:
Originally Posted by roger1818 View Post
When I was in Montreal last December, I noticed one of their bus stops at a relatively minor stop (though on a busy street) had the billboard on the bus shelter replaced with a digital billboard and it would periodically show when the next buses were expected to arrive. That could certainly be one solution.
Coincidentally, in the news today the STO was saying they will be installing more of these electronic signs at stops across the city.

At the moment I believe all Rapibus stations and park and ride terminals are covered. So they're going to be hitting major stops along boulevards now.
__________________
Loin des yeux, loin du coeur.


  #10228
Old Posted Apr 18, 2019, 2:57 PM
cprail's Avatar
cprail cprail is offline
karatéka

Join Date: Dec 2004
Location: Montréal, Québec
Posts: 238
Quote:
Originally Posted by kmcamp View Post

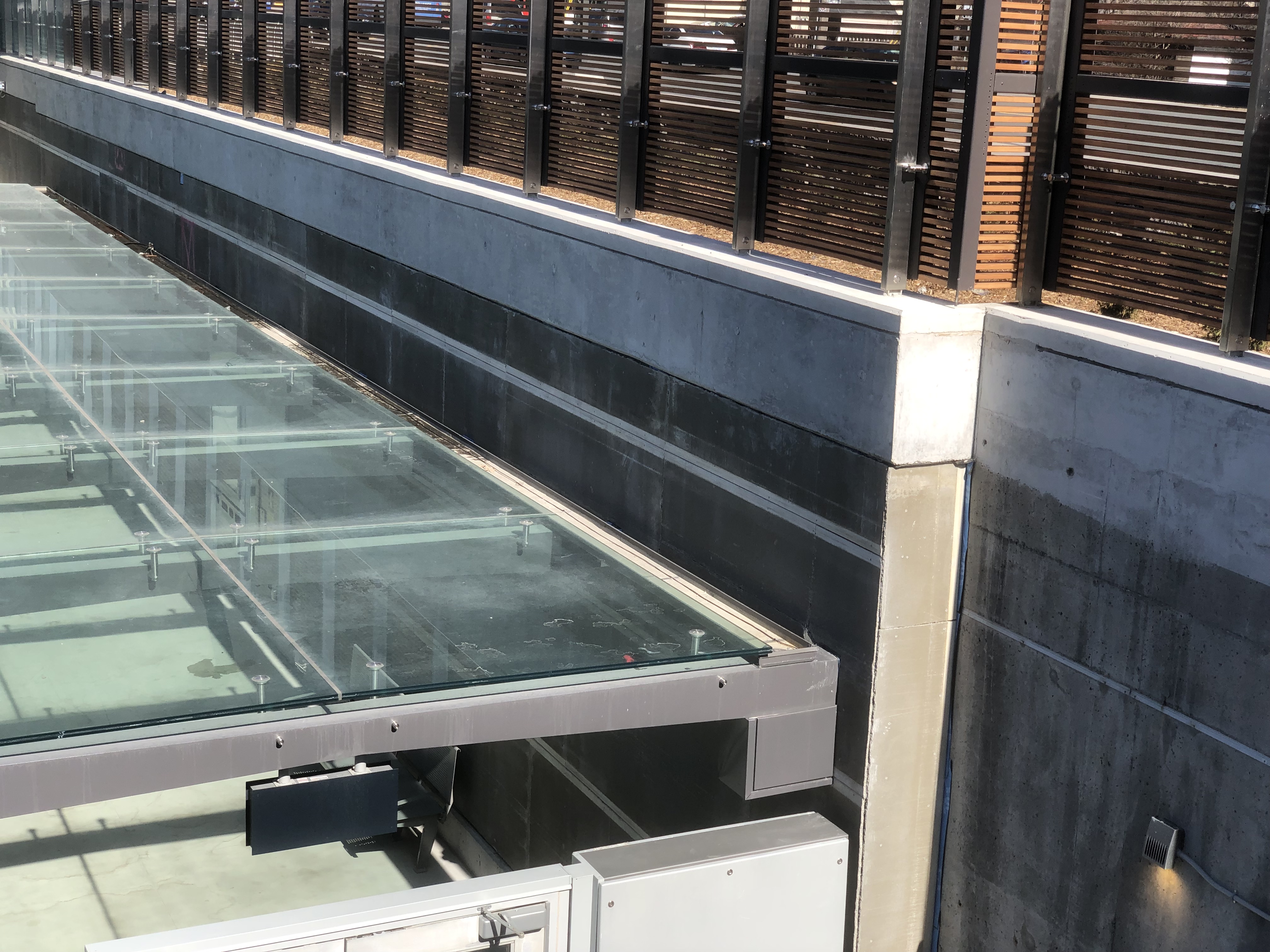

Not a mural, but coloured glass. I actually was wondering if the unfinished looking walls are really just a protective cover for now.
I took a close up picture of the walls yesterday; whether those fiber cement boards are covering the glass or not and if they are short term temporary or not is still, I believe, debatable.


  #10229
Old Posted Apr 18, 2019, 4:22 PM
J.OT13's Avatar
J.OT13 J.OT13 is offline
Moderator

Join Date: Mar 2012
Location: Ottawa
Posts: 28,773


  #10230
Old Posted Apr 18, 2019, 9:45 PM
zzptichka zzptichka is offline
Registered User

Join Date: Dec 2015
Location: Outaouias
Posts: 2,363
Updates from the newsletter

Quote:
Activities Across the Alignment – Construction Update

Tunney’s Pasture, Bayview, Pimisi, St-Laurent, uOttawa, Lees, Hurdman, Tremblay, Cyrville, and Blair Stations have all received occupancy permits. Final paperwork for occupancy permits at Parliament and Lyon Stations is underway. Rideau Station is undergoing final touch-ups such painting, signage installation, and electrical work. Final elevator commissioning is also underway.





Train Testing

Testing and commissioning activities continue to progress:
  • Testing of the CBTC (train control system) continues and 32 out of 34 vehicles have been safety certified for the onboard control system.
  • The last two vehicles are forecast to complete the DPICO shortly (a test done to confirm that all equipment on the train has been installed in accordance with the specification and design).
  • All 34 trains have operated on the guideway as part of the testing process.
  • There is ongoing testing of coupled trains on the alignment. End-to-end performance testing is underway.
  • Commissioning of the communications systems at the Transit Operation Control Centre (TOCC) is ongoing.
  • Power system testing, requiring multiple vehicles travelling the length of the system, is ongoing.
  • OC Transpo’s Electric Rail Operator training is progressing.
  • Weekend operations are becoming a regular occurrence.


  #10231
Old Posted Apr 18, 2019, 10:23 PM
mykl mykl is offline
Registered User

Join Date: Jan 2015
Location: Ottawa
Posts: 475
Things are starting to look very complete, and real, and GOOD! I'm excited!


  #10232
Old Posted Apr 18, 2019, 11:28 PM
Truenorth00 Truenorth00 is offline
Registered User

Join Date: May 2017
Posts: 28,904
Canada Day is looking risky from that update. They won't even have all the vehicles and stations signed off by the end of April. Probably not even mid-May.

Let's hope testing goes well.


  #10233
Old Posted Apr 18, 2019, 11:30 PM
Truenorth00 Truenorth00 is offline
Registered User

Join Date: May 2017
Posts: 28,904
Really wish they put the station names on the lanterns. Right now they are just station markers like the red lifesavers.


  #10234
Old Posted Apr 18, 2019, 11:35 PM
Gat-Train Gat-Train is offline
BANNED

Join Date: Nov 2018
Posts: 508
If 32 trains have been safety-certified, 12-day continuous testing can't be too far off.


  #10235
Old Posted Apr 18, 2019, 11:51 PM
pattherat pattherat is online now
Registered User

Join Date: Nov 2018
Posts: 196
Quote:
Originally Posted by Gat-Train View Post
If 32 trains have been safety-certified, 12-day continuous testing can't be too far off.
Indeed, and they might even be further along than the site notes.

I have long suspected that the website updates were somewhat in arrears, this twitter post from today seems to confirm that (website says 3 stations awaiting occupancy, tweet says only one left):

https://twitter.com/otrainfans613/status/1118922355147931648?s=20


  #10236
Old Posted Apr 19, 2019, 12:14 AM
OCCheetos OCCheetos is offline
Registered User

Join Date: Aug 2017
Posts: 2,110
Quote:
Originally Posted by Truenorth00 View Post
Canada Day is looking risky from that update. They won't even have all the vehicles and stations signed off by the end of April. Probably not even mid-May.

Let's hope testing goes well.
Like mentioned in the other post, Watson said just yesterday that there's only one station left.

This week's update also mentions that the last two vehicles are set to complete their tests "shortly". It's hard to predict but I hope shortly is < 12 days.

Quote:
Originally Posted by Truenorth00 View Post
Really wish they put the station names on the lanterns. Right now they are just station markers like the red lifesavers.
I think they've always intended to put the names on the lanterns, although the design has changed several times. The red O's were only put on recently, so they may still need to apply the names as well.


  #10237
Old Posted Apr 19, 2019, 1:12 AM
CityTech CityTech is offline
Registered User

Join Date: May 2016
Location: Ottawa
Posts: 2,798
Last week it said 29 trains were done. They got from 29/34 to 32/34 in one week. The fleet may very well be completed next week.


  #10238
Old Posted Apr 19, 2019, 5:20 AM
CityTech CityTech is offline
Registered User

Join Date: May 2016
Location: Ottawa
Posts: 2,798
Quote:
Originally Posted by pattherat View Post
Indeed, and they might even be further along than the site notes.

I have long suspected that the website updates were somewhat in arrears, this twitter post from today seems to confirm that (website says 3 stations awaiting occupancy, tweet says only one left):

https://twitter.com/otrainfans613/status/1118922355147931648?s=20
I've long since noticed that over the past few years. Things described as "starting soon" that have already happened, for example.

The wording is that Lyon and Parliament are undergoing "final paperwork for occupancy permits"; their permits may have been granted literally Wednesday or Thursday of this week.


  #10239
Old Posted Apr 19, 2019, 7:45 AM
TheMatth69 TheMatth69 is offline
Registered User

Join Date: Apr 2019
Posts: 158
It has come to my attention while spotting, that trains between Hurdman & Lees, move at a very slow pace (not above 25km/h). I find that kind of curious. Does any body know or have an explanation about this ?


  #10240
Old Posted Apr 19, 2019, 11:30 AM
OtrainUser OtrainUser is offline
Registered User

Join Date: Jul 2017
Posts: 619
Quote:
Originally Posted by TheMatth69 View Post
It has come to my attention while spotting, that trains between Hurdman & Lees, move at a very slow pace (not above 25km/h). I find that kind of curious. Does any body know or have an explanation about this ?

Thats weird when i usually spot those trains they are going twice as fast entering or leaving hurdman station.


This discussion thread continues

Use the page links to the lower-right to go to the next page for additional posts


Closed Thread

Go Back   SkyscraperPage Forum > Regional Sections > Canada > Ontario > Ottawa-Gatineau > Transportation
Forum Jump



Forum Jump


All times are GMT. The time now is 8:30 PM.



Powered by vBulletin® Version 3.8.7
Copyright ©2000 - 2026, vBulletin Solutions, Inc.
