I found pp. 32-35 about Revenue Service Availability (RSA) Timelines interesting:

Quote:
RSA Date Timelines
  • December 2016 - RTG Works Schedule shows RSA on May 24, 2018;
  • December 2016 to May 2017 - RTG continues to issue Works Schedule updates showing RSA on May 24, 2018;
  • December 2016 to May 2017 – the City closely monitors schedule and advises RTG of activities showing a month over month slippage;
  • May 2017 - the City commissions an Independent Assessment Team to undertake a joint review of the schedule without the benefit of the detailed schedule that met the City’s requirements and as requested of RTG to assess the probability of a successful May 24, 2018 RSA date;
  • May 2017 – the City advises RTG that there is a high probability that the RSA date could occur in Q4 2018;
  • May 2017 - RTG did not agree and the PA did not oblige them to change the Works Schedule;
  • May 2017 – Aug 2017 – RTG continues to issue Works Schedule updates showing RSA on May 24, 2018;
  • August 2017 – the City issues the first “Failure to Maintain Schedule Notice” indicating that the May 24, 2018 RSA Date was at risk and requested a “recovery plan”;
  • October 2017 – RTG issues Delay Event Notices for ceiling material and ‘Fare Control’;
  • October 2017 – the City rejects the Delay Event Notices;
  • October 2017 – a follow-up schedule review with the Independent Assessment Team again indicates that the May 24 RSA date is not achievable;
  • November 24, 2017 - RTG submitted the 180 day notice confirming that they would achieve the May 24 RSA date as such date may be amended due to Delay Events and Variations:
  • November 2017 – The City immediately rejects the notice as ambiguous and requests RTG to provide either an unconditional notice that May 24, 2018 will be achieved or provide a new RSA date;
  • December 2017 - RTG submits a revised Works Schedule indicating a RSA date of August 14, 2018;
  • December 2017 – The City rejects the latest Works Schedule and schedules RTG to attend another joint schedule review with the Independent Assessment Team in January 2018;
  • January 2018 – This is the first time RTG provides the detailed schedule meeting the City’s requirements and as requested by the City. This enables a joint schedule review to be undertaken and RTG is informed of the assessment conclusion that there is a low probability of achieving an August 14, 2018 RSA date and that a date in Q4 2018 is more achievable;
  • February 5, 2018 - the City receives a new Works Schedule from RTG indicating a new RSA date of November 2, 2018 subject to the resolution of contractual matters; and,
  • February / March 2018 – negotiations with RTG are ongoing.


  #6767
Old Posted Apr 14, 2018, 5:49 PM
roger1818's Avatar
roger1818 roger1818 is offline
Registered User

Join Date: Feb 2016
Location: Stittsville, ON
Posts: 6,610
Here is a copy of the tweet:

Quote:
Jim Watson
@JimWatsonOttawa

Exciting news: an LRT train has been moved through the O-Train #ConfederationLine tunnel to Tunney’s Pasture Station. We will be running systems tests to make sure every detail is in working order. Keep an eye out! #ready4rail #ottLRT

10:28 AM - 14 Apr 2018 from Ottawa, Ontario


  #6768
Old Posted Apr 14, 2018, 5:59 PM
PHrenetic PHrenetic is offline
Registered User

Join Date: Jun 2016
Location: Ottawa
Posts: 1,029
Quote:
Originally Posted by roger1818 View Post
I found pp. 32-35 about Revenue Service Availability (RSA) Timelines interesting:
Good Day.

yup..... lots of back-and-forth legalistics within which the cost of the lawyers will add up to more than the millions under question.....but it's the point of the thing - to establish precedent.

I found the RTG proposed RSA of 2018.Aug.14 interesting - right on my estimate of 2-3 months total delay. Re-emphasis on the original tight RSA of May 7/24, the probable equally tight Aug.14 deadline, and the loose new deadline of Nov.2 (which RTG will quietly be 'encouraged' to beat - in time for the election !).

Such FUN !


  #6769
Old Posted Apr 14, 2018, 6:41 PM
J.OT13's Avatar
J.OT13 J.OT13 is offline
Moderator

Join Date: Mar 2012
Location: Ottawa
Posts: 28,773


  #6770
Old Posted Apr 14, 2018, 7:08 PM
Kitchissippi's Avatar
Kitchissippi Kitchissippi is offline
Busy Beaver

Join Date: Nov 2005
Location: Ottawa
Posts: 4,681

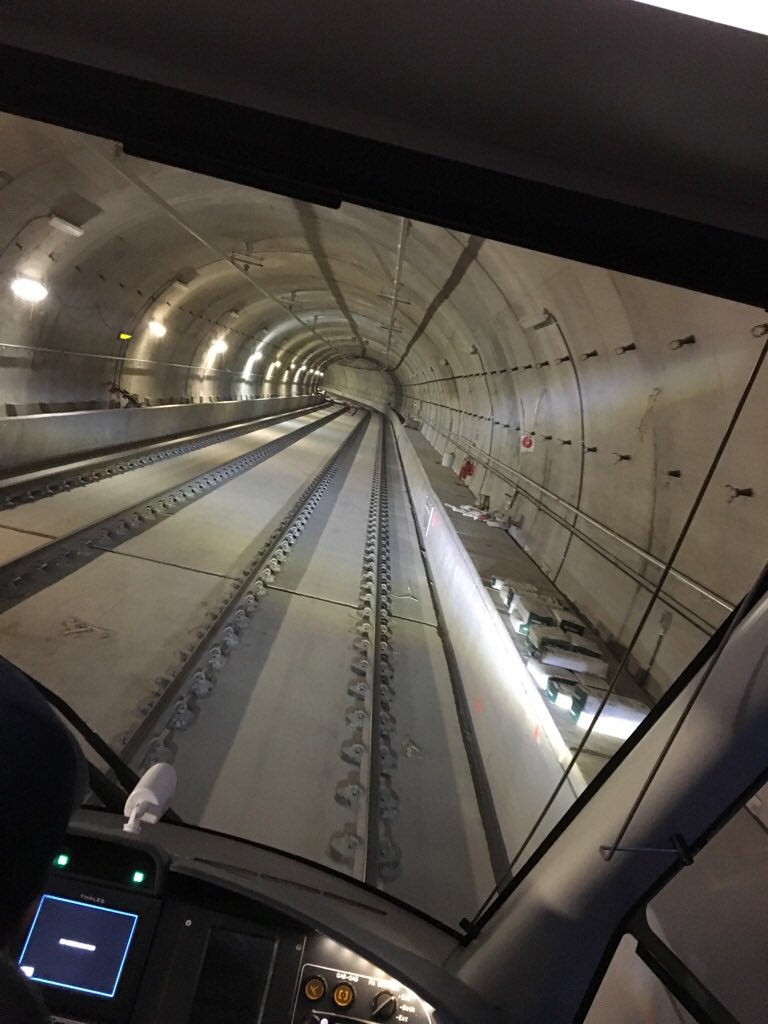

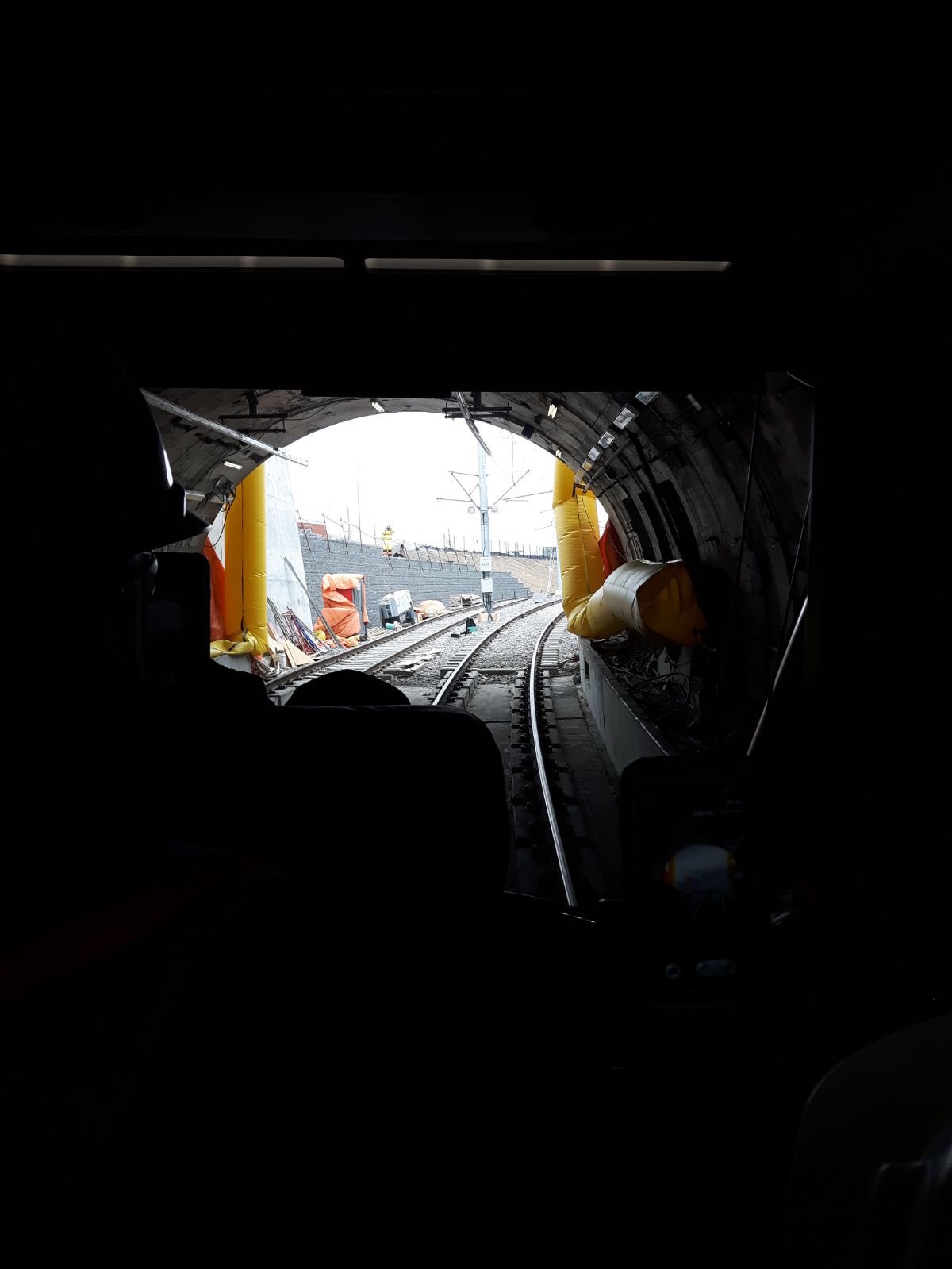

Needs more fanfare:



  #6771
Old Posted Apr 14, 2018, 9:08 PM
roger1818's Avatar
roger1818 roger1818 is offline
Registered User

Join Date: Feb 2016
Location: Stittsville, ON
Posts: 6,610
Quote:
Originally Posted by Kitchissippi View Post
Needs more fanfare:


  #6772
Old Posted Apr 14, 2018, 11:43 PM
J.OT13's Avatar
J.OT13 J.OT13 is offline
Moderator

Join Date: Mar 2012
Location: Ottawa
Posts: 28,773


  #6773
Old Posted Apr 15, 2018, 12:15 AM
bikegypsy's Avatar
bikegypsy bikegypsy is offline
Registered User

Join Date: Aug 2006
Posts: 985
Quote:
Originally Posted by J.OT13 View Post
Looks sick


  #6774
Old Posted Apr 15, 2018, 2:49 AM
swimmer_spe swimmer_spe is offline
BANNED

Join Date: Apr 2014
Posts: 10,743
As far as anyone can tell, has converting the Transitways to LRT been worth it? Or, is it more of a way of securing a ROW?


  #6775
Old Posted Apr 15, 2018, 3:41 AM
roger1818's Avatar
roger1818 roger1818 is offline
Registered User

Join Date: Feb 2016
Location: Stittsville, ON
Posts: 6,610
Quote:
Originally Posted by swimmer_spe View Post
As far as anyone can tell, has converting the Transitways to LRT been worth it? Or, is it more of a way of securing a ROW?
Given that the trains aren't in operation yet, I don't know how anyone can answer that question. We can have the same speculative debates we have been having for the past 5 (or more) years, but we won't know anything until people are using it on a daily basis.

Last edited by roger1818; Apr 15, 2018 at 4:23 AM.


  #6776
Old Posted Apr 15, 2018, 5:59 PM
OtrainUser OtrainUser is offline
Registered User

Join Date: Jul 2017
Posts: 619
Quote:
Originally Posted by roger1818 View Post
Given that the trains aren't in operation yet, I don't know how anyone can answer that question. We can have the same speculative debates we have been having for the past 5 (or more) years, but we won't know anything until people are using it on a daily basis.
Even stage 1 wont solve all the problems, I'm guessing the real improvements will be noticed more when stage 2 is complete.


  #6777
Old Posted Apr 15, 2018, 9:54 PM
roger1818's Avatar
roger1818 roger1818 is offline
Registered User

Join Date: Feb 2016
Location: Stittsville, ON
Posts: 6,610
Quote:
Originally Posted by OtrainUser View Post
Even stage 1 wont solve all the problems, I'm guessing the real improvements will be noticed more when stage 2 is complete.
I partially agree. The big thing I expect to see after stage 1 is an improvement in reliability of the transitway routes. Not having them get stuck in downtown traffic should allow the connexion and rapid buses that connect to the LRT to be more reliable than they are travelling through downtown. Extending further into the suburbs will help improve this reliability. Of course only time will tell if this actually happens.

Last edited by roger1818; Apr 15, 2018 at 10:22 PM.


  #6778
Old Posted Apr 16, 2018, 10:40 AM
McC's Avatar
McC McC is offline
Registered User

Join Date: Apr 2010
Posts: 3,057
Quote:
Originally Posted by Kitchissippi View Post
Needs more fanfare:

The train spent Sunday resting below the RH Coates building under watch of a rentacop parked beside the Scott St MUP.


  #6779
Old Posted Apr 16, 2018, 1:49 PM
Uhuniau Uhuniau is offline
Registered User

Join Date: Jan 2010
Posts: 9,030
Quote:
Originally Posted by J.OT13 View Post
How OC Transpo and the City didn't think the taxpayers might want to have a look at these updates is beyond me.
The lack of openness on the part of the City of Ottawa has always been a problem, but I swear it's gotten worse under Watson. The entire apparatus of municipal government has retreated into a shell of paranoia and secrecy. You can't get a straight, factual, bullshit-free answer about anything by going through official channels. It would be embarassing if it weren't so disgusting.
__________________
___
Enjoy my taxes, Orleans (and Kanata?).


  #6780
Old Posted Apr 16, 2018, 1:50 PM
roger1818's Avatar
roger1818 roger1818 is offline
Registered User

Join Date: Feb 2016
Location: Stittsville, ON
Posts: 6,610
Quote:
Originally Posted by McC View Post
The train spent Sunday resting below the RH Coates building under watch of a rentacop parked beside the Scott St MUP.
Strange they would let it just sit out in the open during a forecasted ice storm. It is one thing to run them in a storm as normal operation will help prevent ice build up on moving parts, but a whole other thing to let it just sit there, unless it is some sort of environmental test they are performing.
