  #3441
Old Posted Aug 11, 2026, 1:25 PM
sseguin sseguin is offline
Registered User

Join Date: Aug 2018
Posts: 315
Rail Fans Canada takes you trackside for an in-depth update on Ottawa’s expanding LRT system. In this video, we show the latest progress on the O-Train Stage 2 West Extension. We also take a look at some of the damage from the rain storm that occurred on Canada Day.

Video Link
__________________
Rail Fans Canada - https://www.RailFans.ca
Reply With Quote


  #3442
Old Posted Aug 12, 2026, 1:07 PM
rocketphish's Avatar
rocketphish rocketphish is offline
Planet Ottawa and beyond

Join Date: Feb 2009
Location: Greater Ottawa
Posts: 14,645
Ottawa councillors 'shocked' by extensive Moodie Station flood damage
Severe damage to key equipment resulted from the surge of water resulting from downpours on Canada Day.

By Aedan Helmer, Ottawa Citizen
Published Aug 12, 2026 | Last updated 4 hours ago


Two west-end councillors who toured the LRT‘s Moodie Station said they were shocked by the extent of the damage caused by flooding on July 1.

College Coun. Laine Johnson and Bay Coun. Theresa Kavanagh toured the station with City of Ottawa and transit officials on Aug. 10 and shared their impressions of the extensive damage in separate social-media posts.

“What I saw, and what I heard, shocked me,” Johnson wrote. “It’s truly a disaster. We are all anxiously awaiting the assessment to know what the impact will be.”

In an interview, Johnson said the nearby Stillwater Creek wetland was overwhelmed by flooding from the intense Canada Day rainstorms as water backed up into Corkstown Yard and the transit station, and also washed out a section of the Queensway.

“It’s amazing the pathway that the water carved, the stone it moved and displaced, the strength of the water,” she said. “It’s very visible from what has been washed away how powerful that current was.”

The extent of the damage caused by the Canada Day floodwaters has cast doubt on the anticipated summer 2027 opening of the LRT west extension, which will include 11 new O-Train stations west of Tunney’s Pasture, with Line 1 extending to Algonquin Station and a new Line 3 running west to Moodie Station.

OC Transpo general manager Rick Leary told council on July 17 that flooding from the July 1 storm had damaged “a significant amount of the electrical systems and equipment, ballast sections of the track, as well as troughs and cabling” that would require repairs before construction could continue.

Johnson and Kavanagh both pointed out the station was designed to handle flooding, and was equipped with an underground holding tank and a pumping station to divert water away from the building and track infrastructure.

Those measures were not enough “to deal with the volume of water that rushed in on July 1,” Kavanagh wrote. “Seeing the damage up close really drove home how intense the storm was and just how much water rushed through the station in a short period of time.”

Johnson posted several photos of the Aug. 10 tour group and pointed to one that showed a brown line on the wall over their heads, indicating the level the flood water reached above the track.

“So it’s not as if stormwater mitigation had not been considered in the construction of this station, but this particular historic storm absolutely overwhelmed what was there,” Johnson said. “And it’s the same story really for all of the neighborhoods that were affected on July 1.”

The water “had nowhere to go” and pooled in the guideway, Johnson said. “And that was around six feet high, so it was a very significant amount of water in a very short amount of time.”

Ballast stone, which helps hold tracks and ties in place, was largely washed away, Johnson said, and much of the remaining stone will need to be replaced. The tracks will need to be replaced, as will sections of the overhead catenary system that powers the O-Train, Johnson said.

Electrical equipment was damaged and will also need to be replaced, Johnson said, which will take time to manufacture and ship to Ottawa.

Months of work were “undone” by the flooding, she said.

The city’s transit services department issued a memo to councillors on Aug. 5 outlining some of the damage to the west extension and said, “No determinations have been made regarding the repairs that may be required.”

The west extension stations and the 15-kilometre length of new track were being inspected “to determine impacts following the July 1 extreme weather event,” according to the memo from Richard Holder, director of the city’s rail construction program.

“This includes examining infrastructure such as electrical equipment, rail switches, ballast and sections of the track,” Holder wrote. “As shared at council (on July 15), preliminary information does indicate that a section of the line in the Moodie Station area will require repairs to electrical equipment, sections of track and ballast and other infrastructure.”

Holder said his team had conducted on-site visits and was meeting regularly with construction consortium East-West Connectors on the repair work and the “progress towards completion.”

The city has hired an external consultant to assess the overall schedule for the Stage 2 west extension, with a full update expected in early 2027. Councillors are to be updated at the next transit committee meeting on Sept. 10.

Johnson and Kavanagh each said they had asked transit officials for regular updates and both suggested exploring a “staged” opening for the west extension.

“I have asked to have the rest of the western extension (stations) open when they’re done, and staff are reviewing what they can do,” Johnson said.

“I’m also pushing for alternative approaches to opening the west extension, given the extensive work that will be needed in this section,” Kavanagh wrote.

The city’s consultant will be “looking at many ways to mitigate project timelines, including the potential for a staged opening,” Holder said. “However, this is still a very preliminary option that must be fully examined and any conclusion to this effect is premature.”

[email protected]

https://ottawacitizen.com/news/moodie-station-flood-damage
Reply With Quote


  #3443
Old Posted Aug 12, 2026, 1:08 PM
rocketphish's Avatar
rocketphish rocketphish is offline
Planet Ottawa and beyond

Join Date: Feb 2009
Location: Greater Ottawa
Posts: 14,645
Future Moodie LRT station singled out for repairs as officials assess flood damage

CBC News
August 11, 2026


The tracks near Moodie station near Bells Corners were largely washed out by the flooding on Canada Day, damage that may end up delaying the opening of the LRT’s western expansion. The CBC’s Cameron Mahler reports.

https://www.cbc.ca/player/play/video/9.7303858
1m44s
Reply With Quote


  #3444
Old Posted Aug 12, 2026, 5:41 PM
rocketphish's Avatar
rocketphish rocketphish is offline
Planet Ottawa and beyond

Join Date: Feb 2009
Location: Greater Ottawa
Posts: 14,645
I couldn't pass up screengrabbing this juxtaposition from today's Ottawa Citizen


https://ottawacitizen.com/
Reply With Quote


  #3445
Old Posted Aug 12, 2026, 6:21 PM
Uhuniau Uhuniau is offline
Registered User

Join Date: Jan 2010
Posts: 9,075
Art.
__________________
___
Enjoy my taxes, Orleans (and Kanata?).
Reply With Quote


  #3446
Old Posted Aug 12, 2026, 7:27 PM
ponyboycurtis's Avatar
ponyboycurtis ponyboycurtis is offline
Cigritbutt enthusiast

Join Date: Apr 2021
Location: Blahttawa
Posts: 1,672
I cackled...

So far even August is looking pretty rainy. We got more coming up. For one.. I am loving how lush and green everything is, but significant weather events that cause damages certainly aren't ideal.

I feel like I have never seen every lawn I pass by green at this time of year. Ditto for 45 days ago. Usually mid July everything is brown aside from shady patches.

Good thing we at least built that big storage tank to mitigate storm drains a couple years ago.
__________________
I don't understand how communism works.
Reply With Quote


  #3447
Old Posted Aug 26, 2026, 8:19 PM
rocketphish's Avatar
rocketphish rocketphish is offline
Planet Ottawa and beyond

Join Date: Feb 2009
Location: Greater Ottawa
Posts: 14,645
Moodie station will need 'redesign' due to storm damage: OC Transpo GM
'I just can't put the exact type of system back,' Rick Leary tells town hall

Guy Quenneville · CBC News
Posted: Aug 26, 2026 4:01 PM EDT | Last Updated: 14 minutes ago


The head of OC Transpo says the damage wrought by the July 1 storm on the LRT's western extension terminus was so severe that he's loathe to re-install the same infrastructure there — meaning the stop will need a redesign.

"I just can't put the exact type of system back," Rick Leary said of Moodie station. "That means going at a redesign."

Leary's remarks, made Tuesday evening during an OC Transpo town hall in Kanata, are not entirely surprising given previous comments about the state the station following the Canada Day deluge.

Preliminary information suggested floodwater had significantly damaged the station, Leary has previously said. After getting a tour of the site earlier this month, College ward Coun. Laine Johnson said the extent of that damage was shocking.

But Leary's latest comments shed new light on what he called the "really substantial" issues at Moodie station — and raise further questions about when the western extension, already behind schedule, will open.

Even the time frame for any new design of Moodie station is unclear, he said Tuesday.

"I have to look at what the design is going to be, the time frame for the design," said Leary, whose hiring was announced in March.

"Some of my staff are looking at me like, 'Here he goes again, he's going to speak too much,'" he added, drawing chuckles from the audience at the town hall.

Tuesday's event was the last in a series of "customer information sessions" meant to draw feedback about the beleaguered public transit service.

At some point the conversation turned to Moodie station, prompting Leary to speak about the significant damage caused by the flash flooding on Canada Day.

"I have to make a decision rather quickly on what we're gonna do going forward," he said.

Leary said he's expecting a report about the damage in mid-September, including "what has to be replaced."

"I'd be remiss to put the exact same thing back, recognizing it could be washed away," Leary said, listing some of the required remediation. "Three-hundred metres plus [of] ballast pulled out, electrical systems pulled out, track bent.... The power of water is really amazing."

The O-Train extension to Moodie Drive and Algonquin College was among many key pieces of infrastructure damaged by the Canada Day storm.

<more>

https://www.cbc.ca/news/canada/ottawa/ottawa-city-hall-election-2026-9.7321168
Reply With Quote


  #3448
Old Posted Aug 26, 2026, 10:42 PM
kwoldtimer kwoldtimer is offline
Registered User

Join Date: Jan 2008
Location: La vraie capitale
Posts: 26,221
So, line to Algonquin by end of 2027 and to Moodie about a year later? Or am I too optimistic?
Reply With Quote


  #3449
Old Posted Aug 27, 2026, 12:04 AM
Richard Eade Richard Eade is offline
Registered User

Join Date: Mar 2008
Location: Nepean
Posts: 2,647
I can’t help but to thing that people are confusing the actual Moodie Station with the Corkstown Yard LMSF. People who should know better, seem to be making references to the wrong location.

From what I have seen, the Moodie Station and the tracks beside it were NOT damaged on July 1, 2026. There should be NO NEED to replace or modify the tracks or signaling in that area. There may be some electronics that need to be dried out.

However, almost 450 metres west of Moodie Station, torrential stormwater flow did wash out a section of track and the signal/control cables, and the switch heater. There is a stretch of about 300 metres there that will need to be cleaned up and rebuilt. That extends from just east of the Corkstown Yard building to approximately half way between Moodie Drive and the NB->WB circular ramp.

There should be no reason that LRT vehicle can not get from Lincoln Fields Station to Moodie Station. And there is a cross-track switch about 400 metres east of Moodie Station, so the trains can be traveling on the correct track by the time they get back to Bayshore Station.

Yes, the connection to the Corkstown Yard needs to be rebuilt (probably differently). Yes, there needs to be much more thought put into a drainage plan for the Corkstown Yard. But, No, the actual Moodie Station itself does not need to be reworked.

I’m thinking that the storm is simply being used as a scapegoat for more construction delays that have been piling up. Effectively, they can now split the West Extension into two parts. They can concentrate work on the branch to Algonquin Station and get it done (mostly) on time, and leave the Line 3 portion until later – with justification for it being much later.
Reply With Quote


  #3450
Old Posted Aug 27, 2026, 1:45 AM
kwoldtimer kwoldtimer is offline
Registered User

Join Date: Jan 2008
Location: La vraie capitale
Posts: 26,221
Quote:
Originally Posted by Richard Eade View Post
I can’t help but to thing that people are confusing the actual Moodie Station with the Corkstown Yard LMSF. People who should know better, seem to be making references to the wrong location.

From what I have seen, the Moodie Station and the tracks beside it were NOT damaged on July 1, 2026. There should be NO NEED to replace or modify the tracks or signaling in that area. There may be some electronics that need to be dried out.

However, almost 450 metres west of Moodie Station, torrential stormwater flow did wash out a section of track and the signal/control cables, and the switch heater. There is a stretch of about 300 metres there that will need to be cleaned up and rebuilt. That extends from just east of the Corkstown Yard building to approximately half way between Moodie Drive and the NB->WB circular ramp.

There should be no reason that LRT vehicle can not get from Lincoln Fields Station to Moodie Station. And there is a cross-track switch about 400 metres east of Moodie Station, so the trains can be traveling on the correct track by the time they get back to Bayshore Station.

Yes, the connection to the Corkstown Yard needs to be rebuilt (probably differently). Yes, there needs to be much more thought put into a drainage plan for the Corkstown Yard. But, No, the actual Moodie Station itself does not need to be reworked.

I’m thinking that the storm is simply being used as a scapegoat for more construction delays that have been piling up. Effectively, they can now split the West Extension into two parts. They can concentrate work on the branch to Algonquin Station and get it done (mostly) on time, and leave the Line 3 portion until later – with justification for it being much later.
So when the head of OC Transpo speaks about Moodie Station, he's confusing the station with the train yard? That's rather sobering.
Reply With Quote


  #3451
Old Posted Aug 27, 2026, 4:33 PM
Richard Eade Richard Eade is offline
Registered User

Join Date: Mar 2008
Location: Nepean
Posts: 2,647
Well, look for yourself:



The only part that experienced any major damage is the connection into the Corkstown Yard LMSF. There is nothing stopping trains from reaching Moodie Station and then reversing out, just as they would do at every other terminal station.

To be fair, the damage is in the vicinity of the Moodie Drive overpass, and its ramps to Highway 417. It MIGHT be that the name Moodie is being used very loosely. However, when they add the identifier ‘Station’, it becomes less factual.

Ergo, I now believe that the damage from the July 1, 2026 rain has become a convenient reason for declaring a delay without admitting that the work has fallen behind schedule.

There have been numerous news reports that the consortium, East West Connectors, is experiencing delays on the western extension. City committees are usually told that they are investigating ways to get back on track – to mitigate the delays. Well, now they have a way. They will split the job, and move resources to speed up work on the Line 1 branch – to Algonquin – and save the Line 3 branch for later. Yes, Line 3 will open much later than the original estimated opening for the entire west extension, but now there is an excuse that they can point to.

Will repairs take extra time? Absolutely. And there should be some proper design for stormwater management, but that affects the connection to the Corkstown Yard LMSF – which is further along the line from the Moodie Station. In the meantime, vehicles can be stored in the Algonquin Station tunnel, and any LRV maintenance would need to be done at the Belfast Yard MSF.
Reply With Quote


  #3452
Old Posted Aug 27, 2026, 7:31 PM
Williamoforange's Avatar
Williamoforange Williamoforange is offline
Registered User

Join Date: Sep 2020
Location: Ottawa
Posts: 868
Quote:
Originally Posted by Richard Eade View Post
Well, look for yourself:



The only part that experienced any major damage is the connection into the Corkstown Yard LMSF. There is nothing stopping trains from reaching Moodie Station and then reversing out, just as they would do at every other terminal station.

To be fair, the damage is in the vicinity of the Moodie Drive overpass, and its ramps to Highway 417. It MIGHT be that the name Moodie is being used very loosely. However, when they add the identifier ‘Station’, it becomes less factual.

Ergo, I now believe that the damage from the July 1, 2026 rain has become a convenient reason for declaring a delay without admitting that the work has fallen behind schedule.

There have been numerous news reports that the consortium, East West Connectors, is experiencing delays on the western extension. City committees are usually told that they are investigating ways to get back on track – to mitigate the delays. Well, now they have a way. They will split the job, and move resources to speed up work on the Line 1 branch – to Algonquin – and save the Line 3 branch for later. Yes, Line 3 will open much later than the original estimated opening for the entire west extension, but now there is an excuse that they can point to.

Will repairs take extra time? Absolutely. And there should be some proper design for stormwater management, but that affects the connection to the Corkstown Yard LMSF – which is further along the line from the Moodie Station. In the meantime, vehicles can be stored in the Algonquin Station tunnel, and any LRV maintenance would need to be done at the Belfast Yard MSF.
Where did you get that picture from? As I've been wondering where the damage actually was since the report.

Also, I also assumed the solution to this was 1) the station equipment Like storm pumps being active 2) that the city would realize that a storm water pond is required between bells corners and the river, & one in Trend village.
Reply With Quote


  #3453
Old Posted Aug 28, 2026, 1:43 PM
Richard Eade Richard Eade is offline
Registered User

Join Date: Mar 2008
Location: Nepean
Posts: 2,647

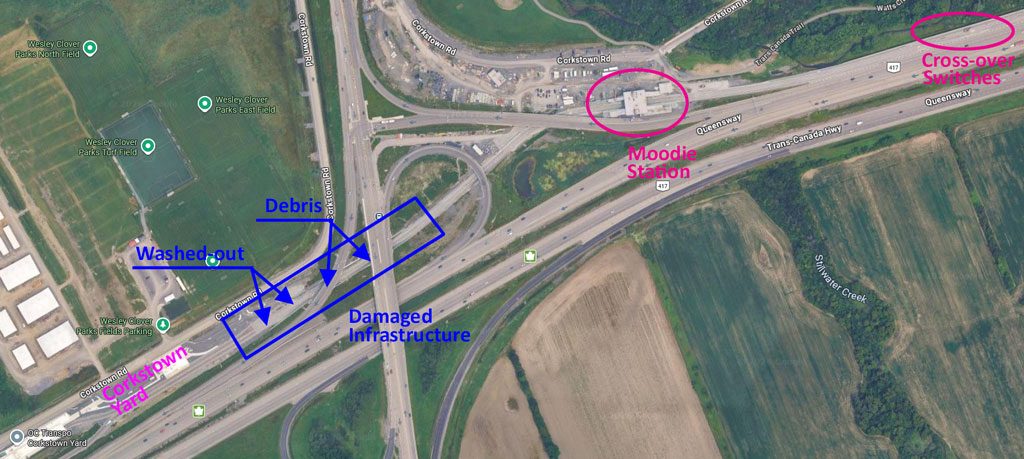

The image is my annotations on a Google Maps base. It represents my own observations of the area two days after the flooding event (so, on July 3, 2026). I have previously posted more information and pictures, back in post # 3396 of this thread.
(https://skyscraperpage.com/forum/showpost.php?p=10621444&postcount=3396)

The track into the Corkstown Yard LMSF is the only area where FAST-MOVING water resulted in a wash-out. Several other stations, and the Parkway Tunnel – in fact, I suspect all of the low-lying areas – had stormwater collect in them, but it was relatively slow-moving water that did little to no damage. Mostly, those areas needed to be pumped out (if the water didn’t eventually drain away by itself), dried out, cleaned, and checked for proper function.

As proof that the infiltration of slower-moving water was not catastrophic, I point out that on August 4, 2026, they were able to ‘walk’ the first train from Tunney’s Pasture Station, through the Parkway Tunnel, past the wetted Sherbourne and New Orchard stations, all the way to Algonquin Station. If simply having water pool in an area was a major issue, that would not have been possible, so soon after the flooding.
Reply With Quote


  #3454
Old Posted Aug 28, 2026, 1:47 PM
OTownandDown OTownandDown is offline
Registered User

Join Date: Jul 2018
Posts: 1,629
Quote:
Originally Posted by Williamoforange View Post
Where did you get that picture from? As I've been wondering where the damage actually was since the report.

Also, I also assumed the solution to this was 1) the station equipment Like storm pumps being active 2) that the city would realize that a storm water pond is required between bells corners and the river, & one in Trend village.
From the photos I've seen, the water came from the small creek directly south of 'Corkstown Yard', flowed over and under the highway at the Trans Canada symbol, essentially hit the berm created by the new infrastructure, flowed down the train tracks to the low portion which is the underpasses, where it was funneled, accelerated, and washed out the granular under the tracks, and everything with it.

The creek *should* flow under the bridges in the yard, and straight north through wesley clover, but the culverts were undersized for the ridiculous amount of rain. I don't think there's a good way to protect against that exact scenario, other than very expensive upgrades to the 417, and absolutely bullet-proofing the tracks.

Edit: Looks to me like maybe Corkstown Road culvert is smaller than the 417 culvert? And if the ditch between the tracks and westbound 417 is flat, this creates a classic overflow scenario, where the water will rise enough either to flow over corkstown road, or continue down the tracks downhill towards Moodie. So the solution might be to open up the culvert at Corkstown. The rail yard is constructed with nice wide open bridges, which is a good call and wouldn't have been the original problem. I still don't think it necessary to excavate the 417 to enlarge the culverts there.

I have a question about 'delay' to the yard being completed. Exactly *where* would the trains originate from that would service Moodie Station and Algonquin? Don't we need a train yard to physically store the quantity of trains required for full service along the full length of track?
Reply With Quote


  #3455
Old Posted Aug 28, 2026, 2:31 PM
SkeggsEggs SkeggsEggs is offline
Registered User

Join Date: May 2016
Posts: 408
Quote:
Originally Posted by Richard Eade View Post
I can’t help but to thing that people are confusing the actual Moodie Station with the Corkstown Yard LMSF. People who should know better, seem to be making references to the wrong location.
in a different article leary is quoted as saying "moodie station area"
Reply With Quote


  #3456
Old Posted Aug 28, 2026, 4:24 PM
Richard Eade Richard Eade is offline
Registered User

Join Date: Mar 2008
Location: Nepean
Posts: 2,647
Well, I’m glad to see that some people are starting to be more precise.

I believe the article that you are referencing was published AFTER my comment. (Although it is hard to tell for sure, since you did not include a link to your article.)

Now, if we could only get people like Richard Holder educated on which O-Train line will run where. (Assuming the reporter got the information correct.)
Quote:
Ottawa’s director of rail construction, Richard Holder, told CTV News Ottawa earlier this month that OC Transpo is looking at opening Line 3 between Tunney’s Pasture and Algonquin College first, with a delayed opening for Line 1 between Tunney’s Pasture and Moodie Station.
From the CTVNEWS article: https://www.ctvnews.ca/ottawa/article/oc...ption-following-canada-day-flood-damage/

From what I have read, I believe that Line 3 is the one that will be running to Moodie Station (and eventually Kanata), while Line 1 is the one running to Algonquin Station. Check for your self at https://www.octranspo.com/en/interactive-map?lat=45.350727771493105&lng=-75.80270290374757&zoom=14
Reply With Quote


  #3457
Old Posted Aug 31, 2026, 2:13 PM
J.OT13's Avatar
J.OT13 J.OT13 is offline
Moderator

Join Date: Mar 2012
Location: Ottawa
Posts: 28,961
Quote:
Originally Posted by Richard Eade View Post
I can’t help but to thing that people are confusing the actual Moodie Station with the Corkstown Yard LMSF. People who should know better, seem to be making references to the wrong location.

From what I have seen, the Moodie Station and the tracks beside it were NOT damaged on July 1, 2026. There should be NO NEED to replace or modify the tracks or signaling in that area. There may be some electronics that need to be dried out.

However, almost 450 metres west of Moodie Station, torrential stormwater flow did wash out a section of track and the signal/control cables, and the switch heater. There is a stretch of about 300 metres there that will need to be cleaned up and rebuilt. That extends from just east of the Corkstown Yard building to approximately half way between Moodie Drive and the NB->WB circular ramp.

There should be no reason that LRT vehicle can not get from Lincoln Fields Station to Moodie Station. And there is a cross-track switch about 400 metres east of Moodie Station, so the trains can be traveling on the correct track by the time they get back to Bayshore Station.

Yes, the connection to the Corkstown Yard needs to be rebuilt (probably differently). Yes, there needs to be much more thought put into a drainage plan for the Corkstown Yard. But, No, the actual Moodie Station itself does not need to be reworked.

I’m thinking that the storm is simply being used as a scapegoat for more construction delays that have been piling up. Effectively, they can now split the West Extension into two parts. They can concentrate work on the branch to Algonquin Station and get it done (mostly) on time, and leave the Line 3 portion until later – with justification for it being much later.
Quote:
Originally Posted by Richard Eade View Post
Well, I’m glad to see that some people are starting to be more precise.

I believe the article that you are referencing was published AFTER my comment. (Although it is hard to tell for sure, since you did not include a link to your article.)

Now, if we could only get people like Richard Holder educated on which O-Train line will run where. (Assuming the reporter got the information correct.)

From the CTVNEWS article: https://www.ctvnews.ca/ottawa/article/oc...ption-following-canada-day-flood-damage/

From what I have read, I believe that Line 3 is the one that will be running to Moodie Station (and eventually Kanata), while Line 1 is the one running to Algonquin Station. Check for your self at https://www.octranspo.com/en/interactive-map?lat=45.350727771493105&lng=-75.80270290374757&zoom=14
I assume OC Transpo references Moodie Station area over Moodie/Corkstown Yards because it's easier to understand for most people who aren't as aware of the project details. The media using Moodie Station is just miss-information.

Line 1 will be Trim to Algonquin while Line 3 will be Trim to Moodie. Hoping CTV confused the two and not Richard Holder.

Even if Line 3 to Moodie is not damaged, it's probably operationally impossible, or at least risky, to open that section without Corkstown Yards being fully operational. Although Belfast can hold the entire fleet, it doesn't provide enough space for smooth operations, even if we're parking a few trains by the Costco in Gloucester, at Lincoln Fields and at Algonquin. It's not just movement within the yard, but maintenance. Corkstown Yards wasn't built for fun.

Best we can hope for is Line 1 opening to Algonquin while while the tracks leading to Corkstown Yards are repaired and drainage improved. Honestly, Line 1 to Algonquin will probably have the greatest positive impact that any of the three east-west extensions, so I wouldn't be massively disappointed with Line 3 being delayed another year or two.
Reply With Quote


End


Reply

Go Back   SkyscraperPage Forum > Regional Sections > Canada > Ontario > Ottawa-Gatineau > Transportation
Forum Jump



Forum Jump


All times are GMT. The time now is 8:43 PM.



Powered by vBulletin® Version 3.8.7
Copyright ©2000 - 2026, vBulletin Solutions, Inc.
