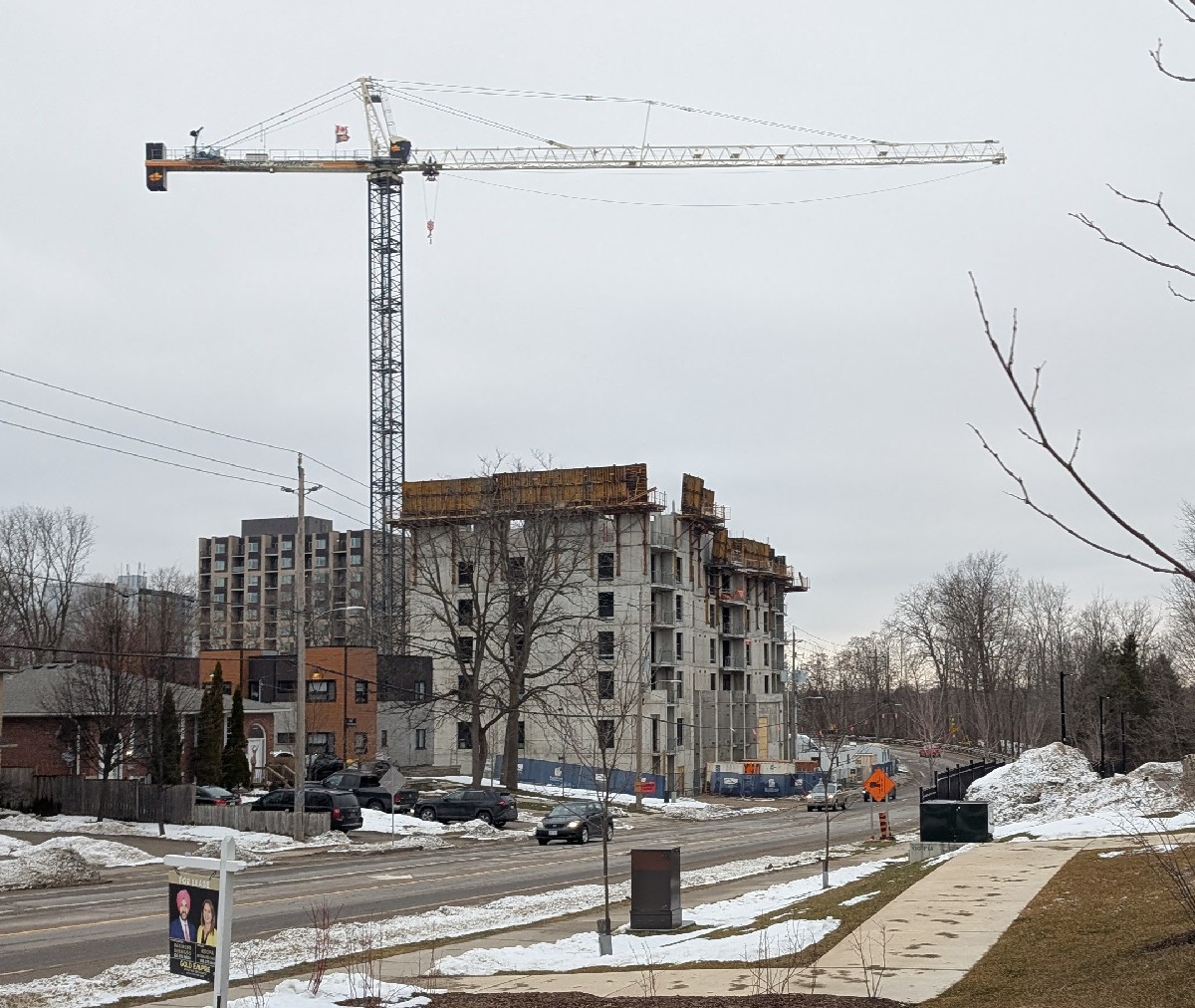

Have now got some of the 4th floor walls poured on the south end. Still need to form the 4th floor slab on the north end. Have also formed another section of the parking garage roof slab as they slowly work their way to the south end of the property. Progress should increase once they have the parking garage poured and they are not dividing their resources between the garage and building.
Wrapping up the 5th floor forming. Have started installing the window and balcony door modules on the lower floors. Forming started on the last section of garage roof slab.
