Here's more MTS TOD info,

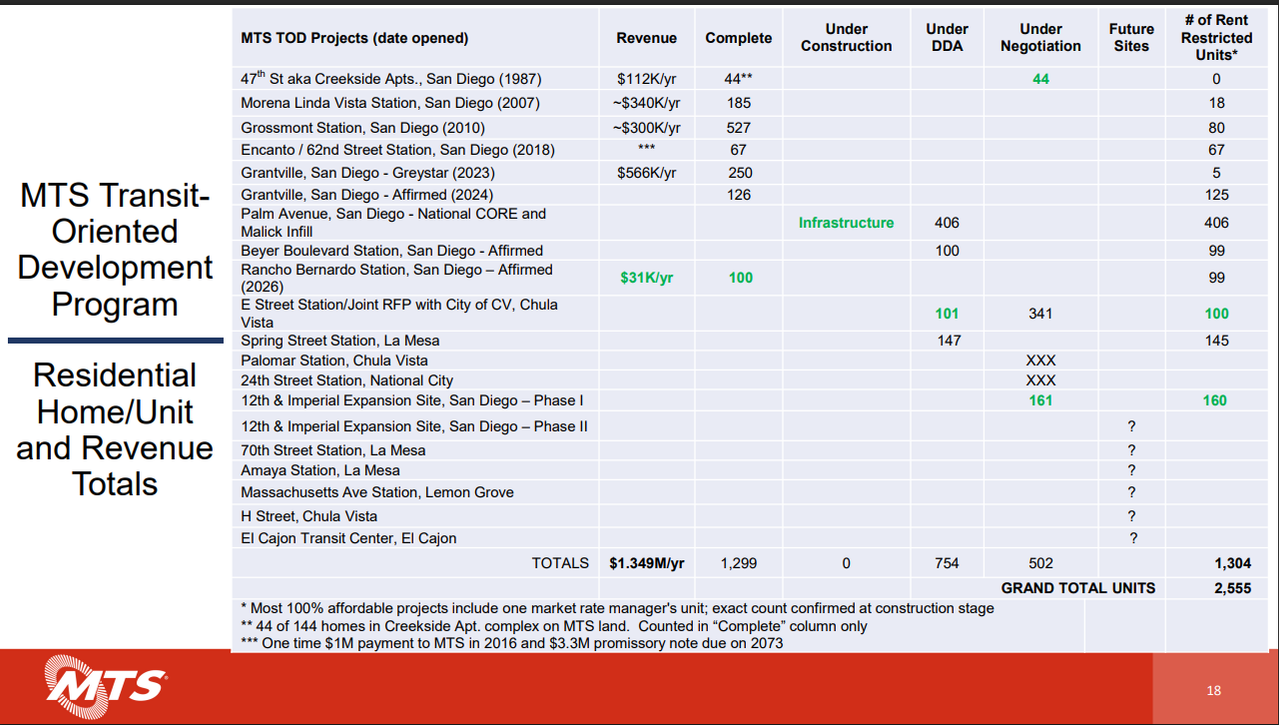

Looks like some other things. The site plan for the Palm Ave TOD has changed for a few reasons but no unit reduction. 406 total units, National Core 304, Malick Infill 102
Infrastructure works ongoing for it and the Palm and Hollister project behind it. Palm Hollister is currently grading. Grading starts in April on the 1st phase.
Spring Street station construction starts in June. 152 units. All Affirmed Housing.
Currently approved 12th and Imperial for one site, 160 units, Cypress Equities. Approved 2025
and Beyer Blvd, 100 units, Affirmed Housing. Approved 2022.
In negations on E Street (post above), 2nd 12th and imperial project, aiming for 20 stories, San Diego Foundation leading negations.
Recieved letters of interest for 24th st and Palomar St from the National Core Malick team.
El Cajon station plans fell thru
Opportunity sites are El Cajon, 70th, Amaya, Massachusetts, and H Street
