HomeDiagramsDatabaseMapsForum About

Go Back   SkyscraperPage Forum > Regional Sections > Canada

Reply

Thread Tools Display Modes

  #7781
Old Posted Nov 12, 2021, 6:39 AM
Chadillaccc's Avatar
Chadillaccc Chadillaccc is offline
ARTchitecture

Join Date: Feb 2011
Location: Cala Ghearraidh
Posts: 22,842
Any idea why The One is going so slowly? Pinnacle One will almost certainly beat it to completion as the first supertall, despite starting around 2 years later.
__________________
Strong & Free

Mohkínstsis — 1.6 million people at the Foothills of the Rocky Mountains, 400 high-rises, a 300-metre SE to NW climb, over 1000 kilometres of pathways, with 20% of the urban area as parkland.
Reply With Quote

  #7782
Old Posted Nov 12, 2021, 12:39 PM
TorontoDrew's Avatar
TorontoDrew TorontoDrew is offline
Registered User

Join Date: Nov 2014
Posts: 10,624
1. It's a more complex build
2. Site restrictions for staging
3. Delays not having permits in place
Reply With Quote

  #7783
Old Posted Nov 12, 2021, 3:37 PM
WhipperSnapper's Avatar
WhipperSnapper WhipperSnapper is offline
I am the law!

Join Date: Sep 2002
Location: Toronto+
Posts: 22,889
The One has the worst location for a tower with a density over 20 FSI. Little area for staging plus imposed restrictions. It's a traffic nightmare to get to the site during daylight hours in any case. Now, I can't believe how little it has progress since July. I'm not counting on a floor every 7 to 10 days.

Last edited by WhipperSnapper; Nov 12, 2021 at 3:51 PM.
Reply With Quote

  #7784
Old Posted Nov 12, 2021, 3:41 PM
travis3000's Avatar
travis3000 travis3000 is offline
Registered User

Join Date: Dec 2012
Location: Simcoe County, ON
Posts: 6,504
The One won't be topped out until at least 2026 lets be real. We should just do quarterly checks on the progress so we can at least see more progress. The pics in the last couple months all look the same. Be better to spread it out.
Reply With Quote

  #7786
Old Posted Nov 15, 2021, 9:35 PM
travis3000's Avatar
travis3000 travis3000 is offline
Registered User

Join Date: Dec 2012
Location: Simcoe County, ON
Posts: 6,504
160 Front is flying now!
Reply With Quote

  #7787
Old Posted Nov 15, 2021, 11:17 PM
WhipperSnapper's Avatar
WhipperSnapper WhipperSnapper is offline
I am the law!

Join Date: Sep 2002
Location: Toronto+
Posts: 22,889
I'm most curious about the curtain wall; more than any other project in Toronto. It doesn't look like we will have to wait too long.
Reply With Quote

  #7788
Old Posted Nov 25, 2021, 6:05 PM
GeneralLea's Avatar
GeneralLea GeneralLea is online now
Midtowner since 2K

Join Date: Aug 2015
Location: Midtown Toronto
Posts: 5,952
__________________
"Living life on the edge"
Reply With Quote

  #7789
Old Posted Nov 25, 2021, 6:55 PM
Biff's Avatar
Biff Biff is online now
What could go wrong?

Join Date: Jun 2004
Location: Winnipeg
Posts: 9,792
I came here to see what "the worker" at The One has been up to this last week.
__________________
"But a city can be smothered by too much reverence for its past. The skyline must keep acquiring new peaks, because the day we consider it complete and untouchable is the day the city begins to die." - Justin Davidson - May 2010 Issue of New York
Reply With Quote

  #7790
Old Posted Nov 25, 2021, 7:27 PM
GeneralLea's Avatar
GeneralLea GeneralLea is online now
Midtowner since 2K

Join Date: Aug 2015
Location: Midtown Toronto
Posts: 5,952
Until I see more substantial movement on site, I'll try to post only on this projects respective thread, apologies. Though it is rather strange seeing how slow this site has been going.
__________________
"Living life on the edge"
Reply With Quote

  #7791
Old Posted Nov 25, 2021, 9:39 PM
WhipperSnapper's Avatar
WhipperSnapper WhipperSnapper is offline
I am the law!

Join Date: Sep 2002
Location: Toronto+
Posts: 22,889
The One worker has made more progress on the main tower in the last week or so than in the previous 5 months. This actually may have a chance to be completed in the 2020s.
Reply With Quote

  #7792
Old Posted Nov 25, 2021, 11:37 PM
giallo's Avatar
giallo giallo is online now
be nice to the crackheads

Join Date: Apr 2002
Location: Vancouver
Posts: 12,637
Quote:
Originally Posted by GeneralLeeTPHLS View Post
Until I see more substantial movement on site, I'll try to post only on this projects respective thread, apologies. Though it is rather strange seeing how slow this site has been going.
Nah, it's fine. Please continue with the updates. Watching a single worker construct Canada's tallest building is fascinating.
Reply With Quote

  #7793
Old Posted Nov 26, 2021, 12:34 AM
WhipperSnapper's Avatar
WhipperSnapper WhipperSnapper is offline
I am the law!

Join Date: Sep 2002
Location: Toronto+
Posts: 22,889
One Yonge's team will surpass The One worker and finish first taking away any chance for The One to be the tallest.
Reply With Quote

  #7794
Old Posted Nov 26, 2021, 12:36 AM
Coldrsx's Avatar
Coldrsx Coldrsx is online now
Community Guy

Join Date: Dec 2003
Location: Edmonton, AB
Posts: 68,924
I don't think people quite appreciate or recognize the vast work that goes into the base structure of a tower, let alone a mega tall.

The UG work/foundation and first couple of floors generally take an order of magnitude as much time to work through versus a typical floor plate.
__________________
"The destructive effects of automobiles are much less a cause than a symptom of our incompetence at city building" - Jane Jacobs 1961ish

Wake me up when I can see skyscrapers
Reply With Quote

  #7795
Old Posted Nov 26, 2021, 12:59 AM
WhipperSnapper's Avatar
WhipperSnapper WhipperSnapper is offline
I am the law!

Join Date: Sep 2002
Location: Toronto+
Posts: 22,889
Are you saying this is 600 metres tall!

Foundations were completed a long time ago. It's been nearly half a year since a suspended slab was poured for the main tower. This has been slow.
Reply With Quote

  #7796
Old Posted Nov 26, 2021, 1:00 AM
Coldrsx's Avatar
Coldrsx Coldrsx is online now
Community Guy

Join Date: Dec 2003
Location: Edmonton, AB
Posts: 68,924
I'd disagree when compared to other towers of similar complexity/size/constrained site.
__________________
"The destructive effects of automobiles are much less a cause than a symptom of our incompetence at city building" - Jane Jacobs 1961ish

Wake me up when I can see skyscrapers
Reply With Quote

  #7797
Old Posted Nov 26, 2021, 1:33 AM
WhipperSnapper's Avatar
WhipperSnapper WhipperSnapper is offline
I am the law!

Join Date: Sep 2002
Location: Toronto+
Posts: 22,889
I can't think of any supertall that took this long to pour one suspended slab. Foundations particularly those with raft slab take a long time to prepare. Like I said, this tower has been past that stage for a long time. It doesn't have a typical concrete core for the podium levels. The weight is rather being transferred onto massive columns. It's unconventional but, it is hardly anti gravity engineering marvel.

Towers with large podiums and underground parking garages take lots of time to climb vertically because the square footage for the underground parking and 5 to 10 floors of podium may be equivalent to the 50 floors above the podium. This is not the situation here either.

I hope it speeds up as it gets past all this weight transferring and onto a more conventional floor plan. I'm not a purchaser. it really doesn't matter if it takes to 2030. For me, it's all in good fun.

I'm probably wrong and, even if I'm right, it's not impactful with the amount of rebar being used and the concrete suspended slabs holding it all together. Waiting months between super column pours will create a weaker bond between the pours compared to a continuous slip pour or whatever it is called .
Reply With Quote

  #7798
Old Posted Dec 9, 2021, 6:42 AM
GeneralLea's Avatar
GeneralLea GeneralLea is online now
Midtowner since 2K

Join Date: Aug 2015
Location: Midtown Toronto
Posts: 5,952
Taken hours ago...from the north

4. 160 Front (Toronto): 240m / 787ft
I was in a bit of a rush today, but I took this on the way to running an errand....it's going to be quite a substantial building once it's done:
Today, Downtown by Draulerin Photographics, on Flickr
Zoomed in (cell phone image....it's the best I could do)
Today, Downtown by Draulerin Photographics, on Flickr
__________________
"Living life on the edge"
Reply With Quote

  #7799
Old Posted Dec 22, 2021, 1:49 AM
GeneralLea's Avatar
GeneralLea GeneralLea is online now
Midtowner since 2K

Join Date: Aug 2015
Location: Midtown Toronto
Posts: 5,952
Taken today

Both 3. M3 @ M City (Mississauga): 260m / 853ft
7. Exchange District Condos 1 (Mississauga): 232m / 761ft
need an update on the list. They both have cranes as my images below show (taken today)
M3:
Construction in Toronto Township by Draulerin Photographics, on Flickr
Construction in Toronto Township by Draulerin Photographics, on Flickr
The Exchange I and II:
Construction in Toronto Township by Draulerin Photographics, on Flickr
__________________
"Living life on the edge"
Reply With Quote

  #7800
Old Posted Dec 22, 2021, 8:02 PM
TorontoDrew's Avatar
TorontoDrew TorontoDrew is offline
Registered User

Join Date: Nov 2014
Posts: 10,624

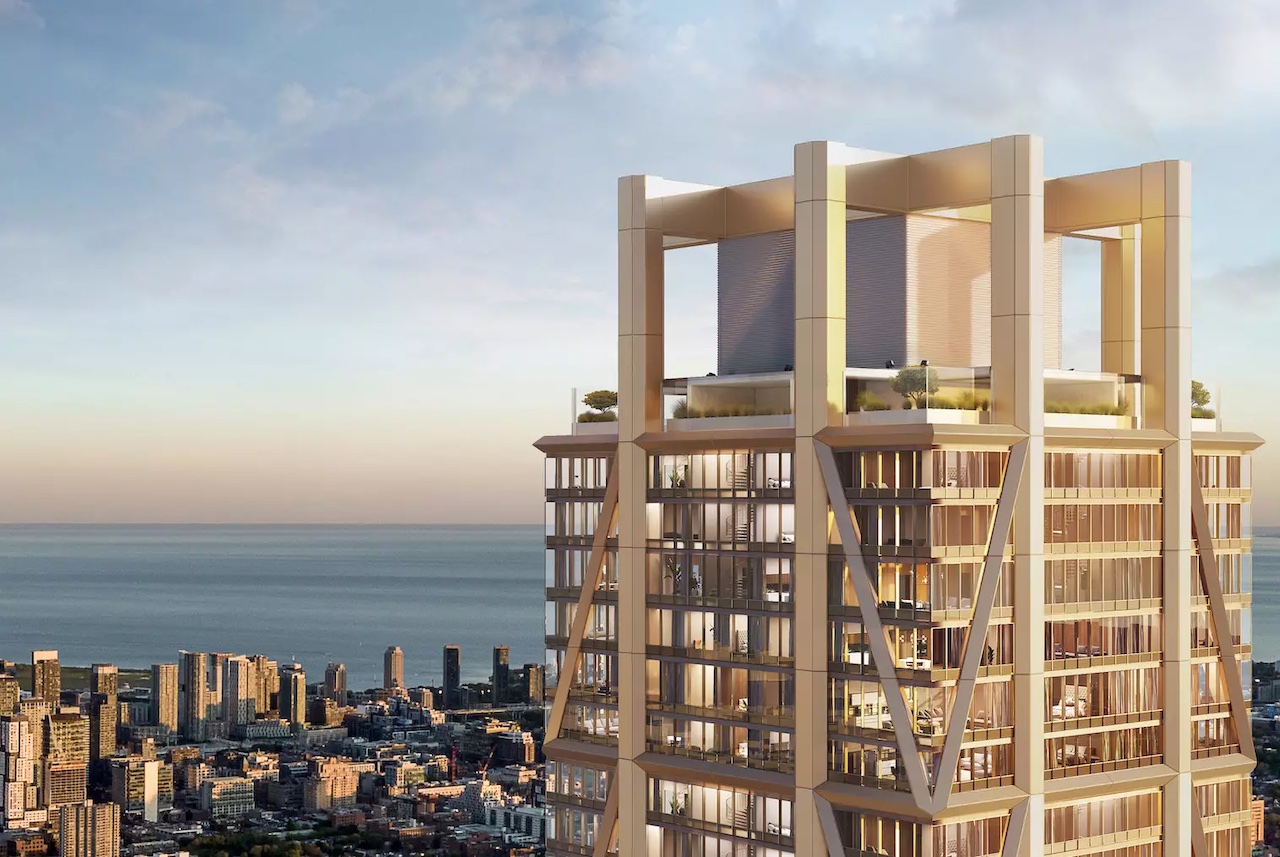

A few new renders of the One's penthouse floors. I was unaware that there will be 4 4 storey penthouses.

Source: urbantoronto.ca

Reply With Quote
